West Dapto Package 3 (Cleveland)

Services for Cleveland development area

We're providing water and wastewater services to an expected 4,500 new homes in the Cleveland development area. The area is part of the West Dapto Urban Release Area (WDURA) and Adjacent Growth Areas (AGAs) in the Illawarra.

About this project

Our South Region Delivery Team D4C is delivering:

  • 3.8 kilometres of new water mains
  • about 10 kilometres of new wastewater pipes
  • upgrade to the existing wastewater pumping station on the corner of Fairwater Drive and Riverpark Way, Horsley.

We've developed a compliance tracking program to track and report compliance against the Minister's Conditions of Approval (MCoA) for this project. This program describes compliance responsibilities and provides a clear and consistent format to demonstrate compliance.

Benefits

Building new water and wastewater networks in the Illawarra will enable new communities to grow.

Impacts

There will be more vehicles, noise and dust around work areas. We will aim to reduce these impacts as much as practicable while finishing the project as quickly as possible. We will restore impacted areas and properties to pre-construction conditions as much as we can. We will temporarily restore roads and footpaths immediately after construction, and arrange for permanent restoration after the full pipeline has been built and tested.

Project audit results

An Independent Environmental Audit was conducted on 14 January 2025 to assess compliance with construction stage conditions from the Environmental Impact Assessment (EIS) WDURA MP09_0189 to satisfy the requirements of Schedule 3 Condition 3.6(c). The audit report was finalised on 12 February 2025. It captured zero non-conformances, one improvement opportunity and 4 notable practices. The improvement opportunity was a recommendation to update some site maps for the upcoming scope of work.

The notable practices related to:

  • detailed and progressive Erosion and Sediment Control Plans (ESCPs)
  • the implementation of a robust training register and activity-specific environmental training program
  • the use of water-cart filling stations for efficient filling of water trucks and reuse of groundwater to mitigate dust emissions
  • the preparation and implementation of an advanced material and waste tracking system.

Project timeline

2013: Project approval
NSW Minister for Planning and Infrastructure approves plans to build water and sewage systems for the West Dapto area. This includes overall plan for the entire development zone and specific approval to start building initial infrastructure for the first phase of construction.
2016: Concept approval modification approval
Minister for Planning and Infrastructure grants a concept approval modification. Project is renamed Water and Wastewater Servicing of the West Dapto Urban Release Area precincts of Kembla Grange, Sheaffes/Wongawilli and West Horsley.
March to July 2024: New wastewater pressure main
Construction of new 680-metre wastewater pressure main between the existing wastewater pumping station on the corner of Fairwater Drive and Riverpark Way and Bong Bong Road.
May 2024 to August 2025: New wastewater trunk gravity pipelines
Construction of about 9.4 kilometres of new wastewater gravity trunk mains from Darkes Road through to Cleveland Road.
July 2024 to July 2025: Upgrades to existing wastewater pumping station
Upgrades to the existing wastewater pumping station located on the corner of Fairwater Drive and Riverpark Way, Horsley.
January to May 2025 New water main along Bong Bong Road
Construction of new 365-metre water main along Bong Bong Road.
Postponed: New water main along Cleveland Road
Construction of new 3.4-kilometre water main along Cleveland Road.

Project updates

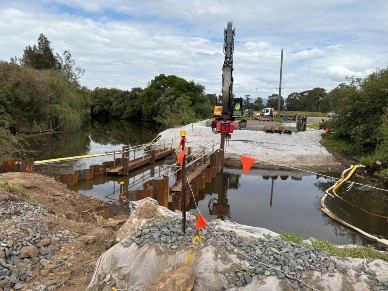

14 April 2025
Strong progress

We're making strong progress across the project and are excited to share some key updates.

Read more
15 January 2025
Returning to work in 2025

We hope you had a restful break over the December and January holiday period. Our crews are now back at work and ready to put their best boot forward to ensure smooth and efficient project delivery.

Read more

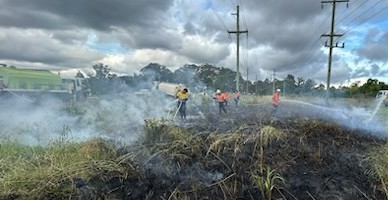

15 November 2024
Shout out to our incredible team

At around 5pm on Tuesday 12 November, our crew spotted smoke billowing across the road from Dapto High School. Without hesitation, they jumped into action, deploying 3 water carts and several team members to contain and extinguish the fire before it could spread.

Read more

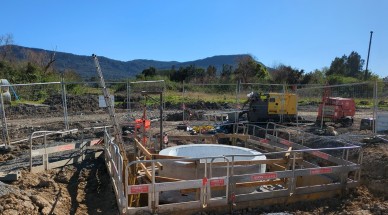

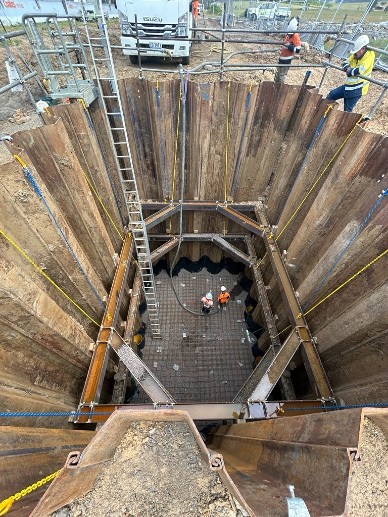

15 October 2024
Sharing some progress statistics

We currently have 6 pipe-laying crews working in the area. These crews install new wastewater pipes by digging a trench, laying the new pipe inside the trench and then filling it. Most new wastewater infrastructure is installed this way. We're not only talking about rural areas, but also busy urban centres like Sydney. These crews have completed 31% of the 7.8-kilometre pipeline between Dapto Road and Cleveland Road, and 88% of the 1.2-kilometre pipeline west of Fowlers Road.

Read more
30 September 2024
Supporting growth in our rural communities

Although we've experienced some delays – mostly due to wet weather and the resulting impact of groundwater – we've now laid over 33,000 metres of pipe, and construction has started on 17 new maintenance holes in the area.

Read more
15 August 2024
Working safely around water bodies

Installing new infrastructure in rural areas comes with its own unique environmental challenges, one of which is how to navigate our work around the lifeblood of rural communities: water!

Read more

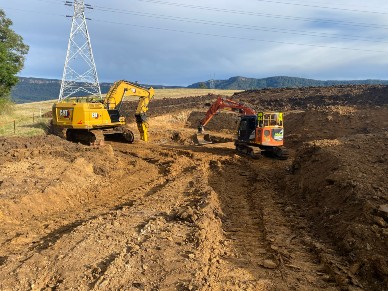

15 July 2024
Connecting the new wastewater pressure main

Work has started to connect the new wastewater main drilled underground between Fairwater Drive and Galway Court in Horsley to the existing wastewater system.

Read more
17 June 2024
Working on multiple fronts this month

Although the wet weather slowed our progress, we're continuing to install the wastewater gravity pipelines as well as tidying up and repairing work areas impacted by rain.

Read more

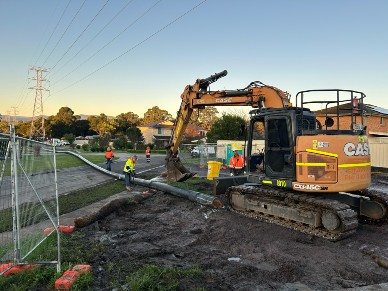

14 May 2024
Fairwater Drive to Galway Court work

A big thankyou to the community around Selwyn Grove, Bridgewater Drive, Boddington Way and Galway Court for their understanding and patience during a long day of work stringing the new wastewater pipeline.

Read more
16 April 2024
Construction underway in Horsley

To date, we've laid over 200 metres of pipe for the new wastewater gravity main.

Read more

05 March 2024
Construction begins in Horsley

This month will see the start of construction for the new wastewater pressure main. We'll start by installing the pipe directly underground via horizontal directional drilling (HDD) technology.

Read more
05 February 2024
Temporary site compound established

We've established our temporary site compound off Cleveland Road, and started constructing temporary access roads through properties that will be used by our vehicles and machinery during construction.

Read more

FAQs

We have a Growth Servicing Plan that outlines the planning and delivery timetable for water and wastewater infrastructure to service urban growth over 5 years.

We deliver infrastructure in stages to meet development timeframes. We work closely with other agencies, including councils and the Department of Planning, Housing and Infrastructure, to ensure we're servicing the right areas at the right times.

Sydney's growth areas are large, with thousands of new homes planned. Because of this, it can take years for the entire area to develop completely. If we build all the infrastructure required for the long term, many assets would be underused for many years.

One of our objectives is to operate as a successful business. This means we must:

  • target our capital expenditure to areas likely to develop in the short term
  • provide a return on our capital investment.

Once an area has been rezoned, developers need to prepare and lodge development applications for the subdivision and development of their properties. This process can a long time, so there's usually a gap between when an area is rezoned and when the first new home is built.

Smaller water pipelines in new release areas are usually laid in road reserves. It's often more efficient and effective to have developers lay the infrastructure as they're building the roads for a new housing development.

We build the major trunk pipelines. Trunk pipes are large water and wastewater pipelines that customers can't connect directly into.

Once the trunk mains have been built, developers usually build the next stage of pipelines (called reticulation or lead-in pipelines) needed to service individual properties.

You don't have to connect to our system if you continue living in your current home. If you wish to build a new home, subdivide or redevelop your land, you need to speak to your local council about any conditions imposed on local developments.

Learn about steps for first-time developers.

We don't provide compensation for building essential infrastructure on private properties. However, we do provide compensation for ventilation shafts and maintenance holes.

Most water pipelines are built in the existing or future roads or nature strips, while wastewater pipelines are designed to follow creek lines, staying within riparian corridors and avoiding developable land where possible.

We may need to acquire private properties or an easement if we must build parts of the water or wastewater network in privately owned property. This would be done in consultation with you at the end of construction.

The Sydney Water Act 1994 gives us powers of entry onto private property for work related to the construction of new infrastructure. We'll work with landowners to minimise impacts on property property where possible.

We try to minimise the impact of our infrastructure on the community. Water and wastewater infrastructure is vital for growth and development of the area, so it provides a long-term benefit.

If your property is directly impacted by our infrastructure, we'll meet with you before any construction happens and be able to provide you with estimated timeframes closer to work starting on your property.
